At MHP-1, wall plastering, roof welding, reinforcement and manual finishing of the discharge channel, and facade wall insulation are underway.

At MHP-2, installation of the sluice, reinforcement and formwork assembly of the drainage channel, and compaction of the pressure basin are being carried out.

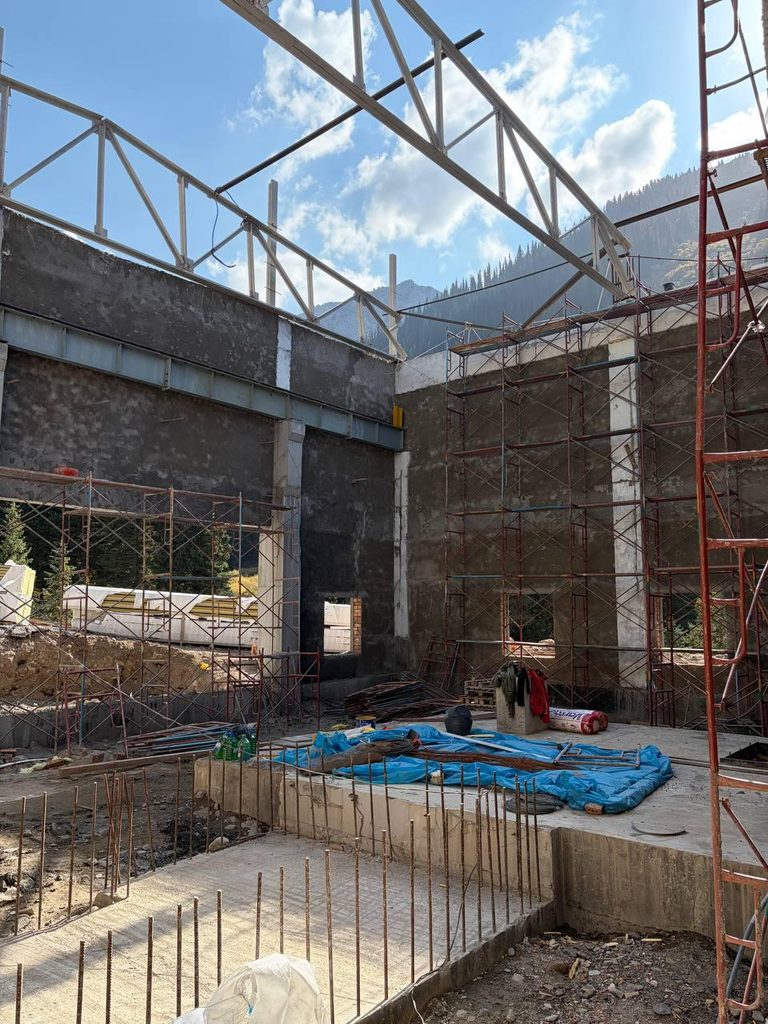

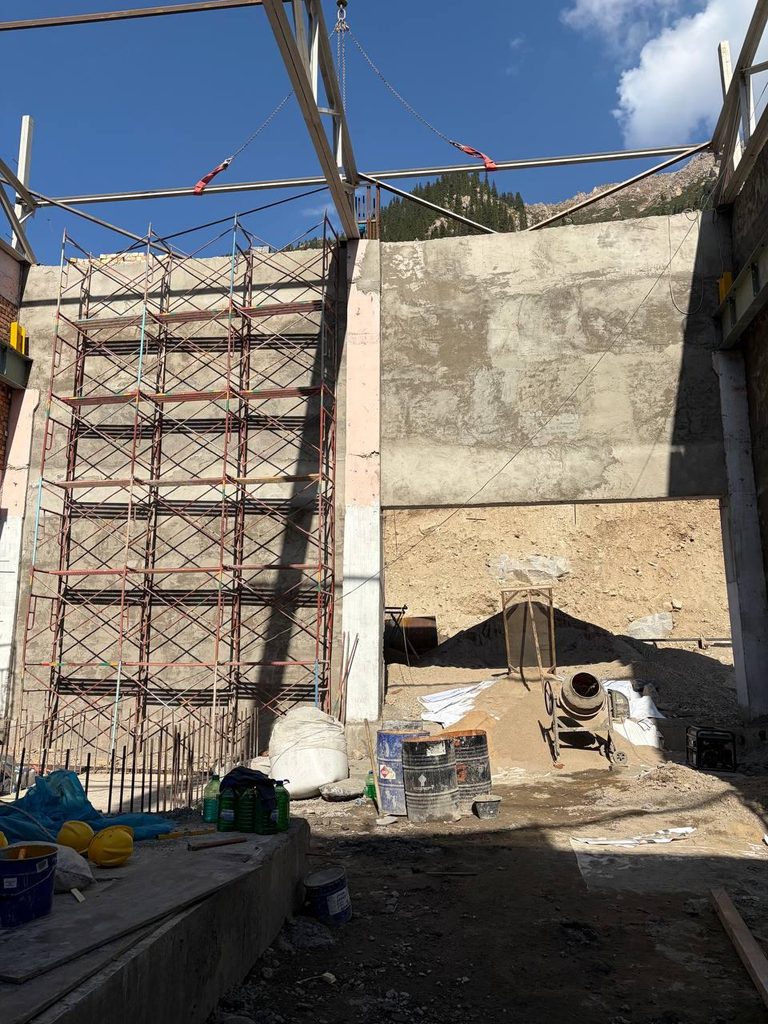

At HPP #3, work is underway to assemble the formwork for the base boot.

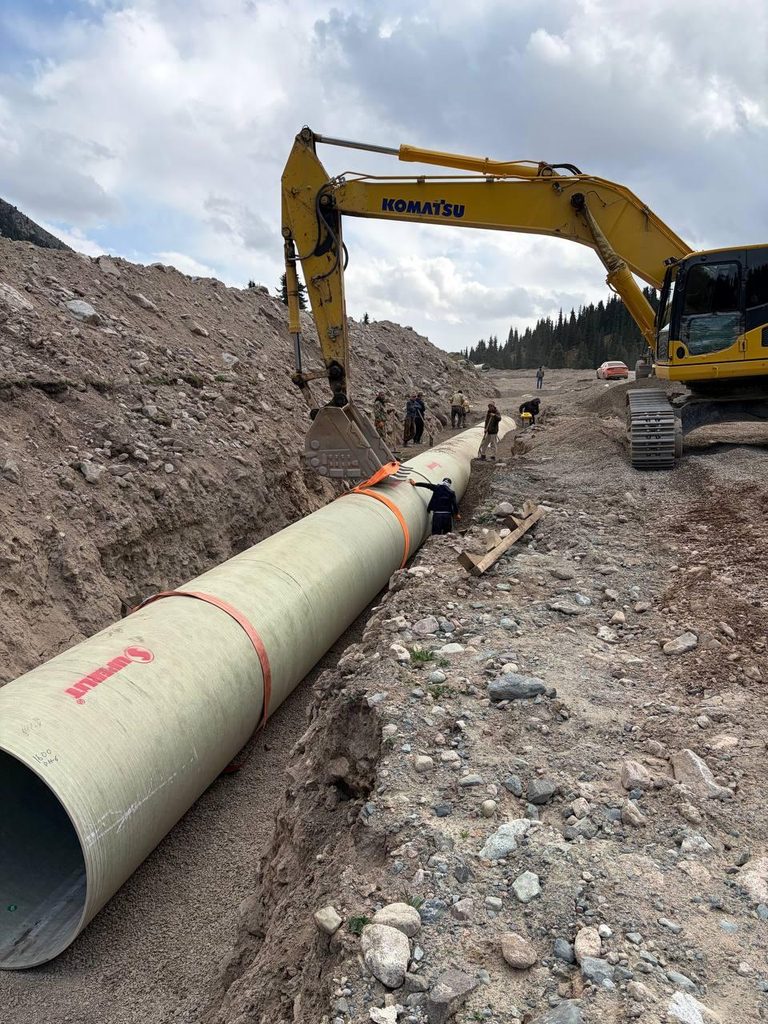

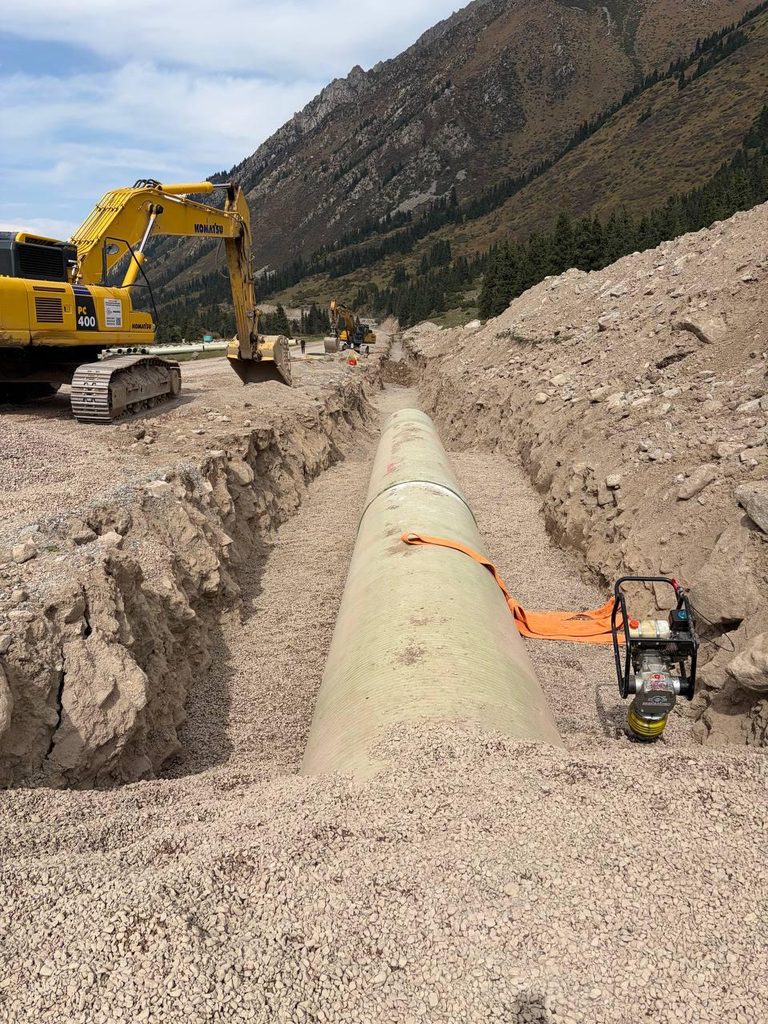

Work on the construction of the headrace channel includes the installation and mounting of GRP pipes.

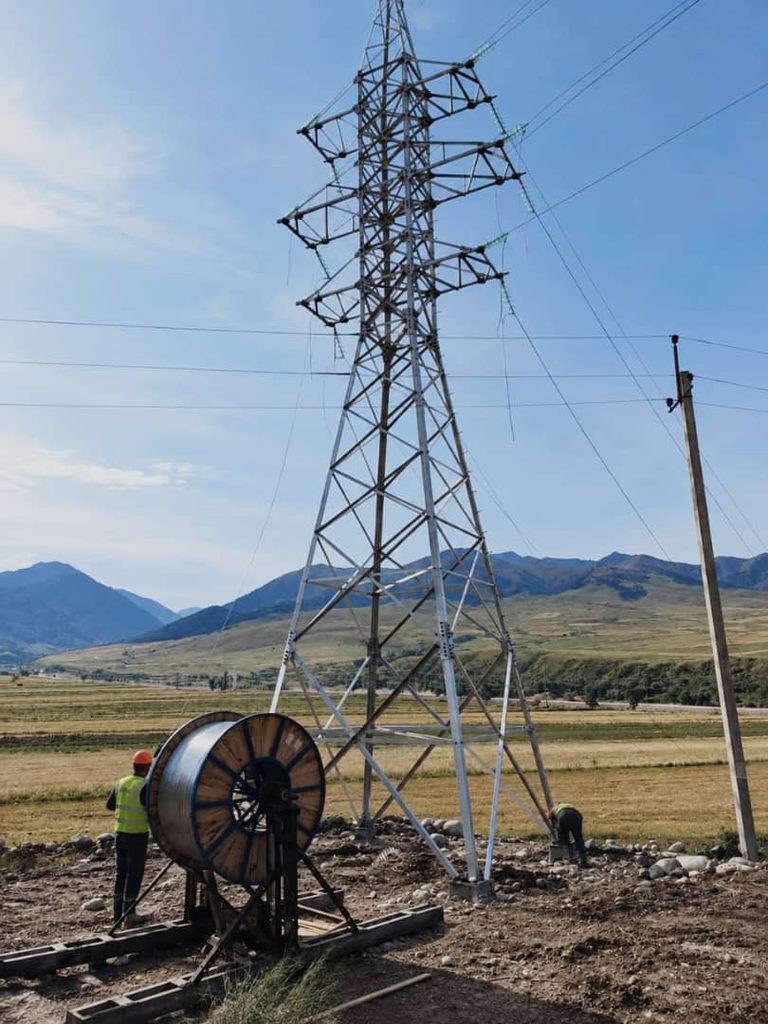

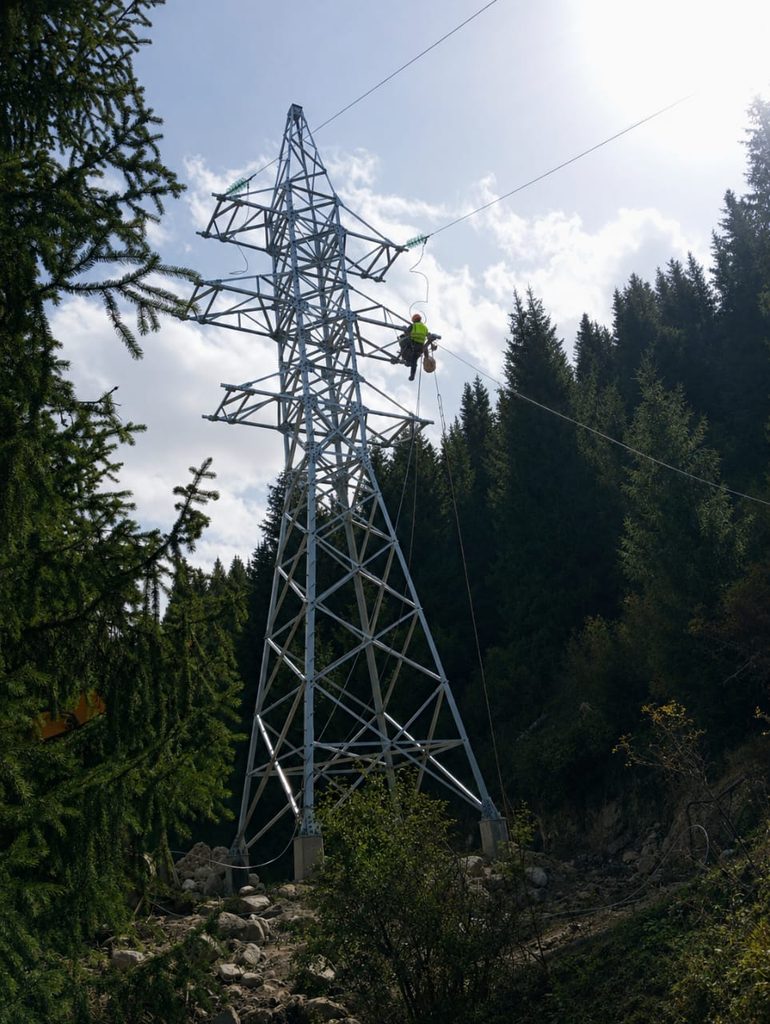

Overhead line work: stringing and installation of AS 120/20 conductors have been completed, along with the assembly and mounting of PS-70 insulator strings, lifting the conductors onto supports, tensioning and sag adjustment, and the final securing of the conductors.
